Nov 21, 2022 – Update

The winter weather has arrived and our construction contractor has assured us they will continue to work hard through the Winter months. We are preparing a project update for the community that will be posted later this week.

Oct 17, 2022 – Update

Our fibre team will begin work this week on the installation of the fibre optic backbone.  This work will take place along Derry Road between Bell School Line and Walker’s Line.  Upon completion of that section the team will then being the same work along Walker’s Line starting at Derry Road and working their way south.  Our team will also be contacting customers in the next two weeks to begin scheduling the installation of service drops to homes and businesses that have subscribed to the service.

We have had some delays due to ground conditions and 3rd party infrastructure that was not locatable due to the age of the infrastructure however our team is working around these areas and doing their best to keep things moving along.

If you have not signed up online please use our online sign up form to ensure that our service is connected to your home.

Aug 29, 2022 – Update

Our construction contractor continues to work in the area, there have been some delays due to ground conditions however they working as quickly as they can to get everything completed. We will be meeting with them this week to review the scope and update any time lines that require changes. That information will be posted to our website in the coming week.

Our field service team will begin the installation of service drop cables in early October for home and businesses that have signed up along Derry Road and Walkers Line.  Service will be available later in October however we want to ensure we get service drops installed before the ground freezes.

If you have not signed up online please use our online sign up form to ensure that our service is connected to your home.

Aug 29, 2022 – Update

Our construction contractor continues to work to build our Fibre To The Home network in the area.  Construction along Walker’s Line is coming along well and in the next few weeks our team will begin to contact homes that have signed up for our service to schedule the installation of our drop service cable.

If you have not already completed our online sign up form please do so to ensure our service is connected to your home.

If you have any questions specific to the physical construction of the network please contact our FTTH Construction Team who can be reached by email ftthconstruction@standardbroadband.ca or telephone at 1-866-304-9117.

Aug 18, 2022 – Update

Over the last month our construction contractor has continue to build out our Fibre To The Home network in the area.  Construction along Derry Road has been completed and our team continues to work along Walkers Line. There have been some minor scheduling conflicts with other work being done that we have had to work around however things are moving along well.

In early September our fibre crew will being to install the fibre optic cable along Derry Road between Appleby and Walkers Line. We will also being to run service drop cables from all clients who have subscribed to the service at this time as well.  Service is expected to be active for Derry Road and Walkers Line (where completed) by early October 2022.  Please use our online sign up form to ensure our service is connected to your home.

If you have any questions specific to the physical construction of the network please contact our FTTH Construction Team who can be reached by email ftthconstruction@standardbroadband.ca or telephone at 1-866-304-9117.

July 18, 2022 – Update

Construction has gone well so far along Derry Road and our team will be completed from Bell School Line to Walker’s Line this week.  We have work at the Walker’s line intersection to complete and due to paving work also being done we have had to coordinate timing but the project remains on track.

This week our team will also be working on Walker’s line prepping the first 1000m of area from Derry Road heading south.  As required by Ontario Law we must locate other underground utilities first and expose them to prevent damage. You may see several holes along the road shoulder and grass areas these holes will be fenced and secured but we do ask that the public stay away from the work areas for everyone’s safety.

July 4, 2022 – Update

Construction has gone well so far along Derry Road and our team will be adding a second crew starting later this week.  One crew will continue work no Derry Road between Appleby Line and Bell School Line while the other crew beings work on Walker’s Line heading south from Derry Road.

The arborist that we are required to have onsite has had a meeting with our construction foreman and reviewed our work area along Walker’s Line.  He will be preparing a report for us and the City of Burlington in the next day or so and then we will be able to proceed along Walker’s line.

Over all the project is on track and moving forward well.

June 27, 2022 – Construction Begins!

Construction continues this week along Derry Road.  Our contractor is aiming to be done work between Appleby and Walkers on Derry by the end of the week.  We will then proceed to construct from Appleby Line to Bell School Line.  More updates to follow as things move along.

If you have any questions specific to the physical construction of the network please contact our FTTH Construction Team who can be reached by email ftthconstruction@standardbroadband.ca or telephone at 1-866-304-9117.

June 20, 2022 – Construction Begins!

Our construction contractor began work today on our Fibre To The Home network. They are currently working between Appleby Line and Walkers Line on Derry Road.

The trailer below contains a reel of what is known as duct, this is what we install in the ground to build the backbone of the network.  Our fibre optic cable is then placed in this duct.  Each reel contains 3km of duct.



Horizontal directional drilling is used to install the duct under the ground. This method of installation keeps the area much cleaner and safer over traditional methods such as open trenching. It does take some time to install.

If you have any questions specific to the physical construction of the network please contact our FTTH Construction Team who can be reached by email ftthconstruction@standardbroadband.ca or telephone at 1-866-304-9117.

June 13, 2022

Construction on our new Fibre To The Home network will being on June 20, 2022 in rural Burlington.  Our construction will be broken in to three construction phases.  Service will be available in each phase as that phase’s construction is completed.  Below is our planned construction schedule as well as a colour coded map showing each of our construction phases.

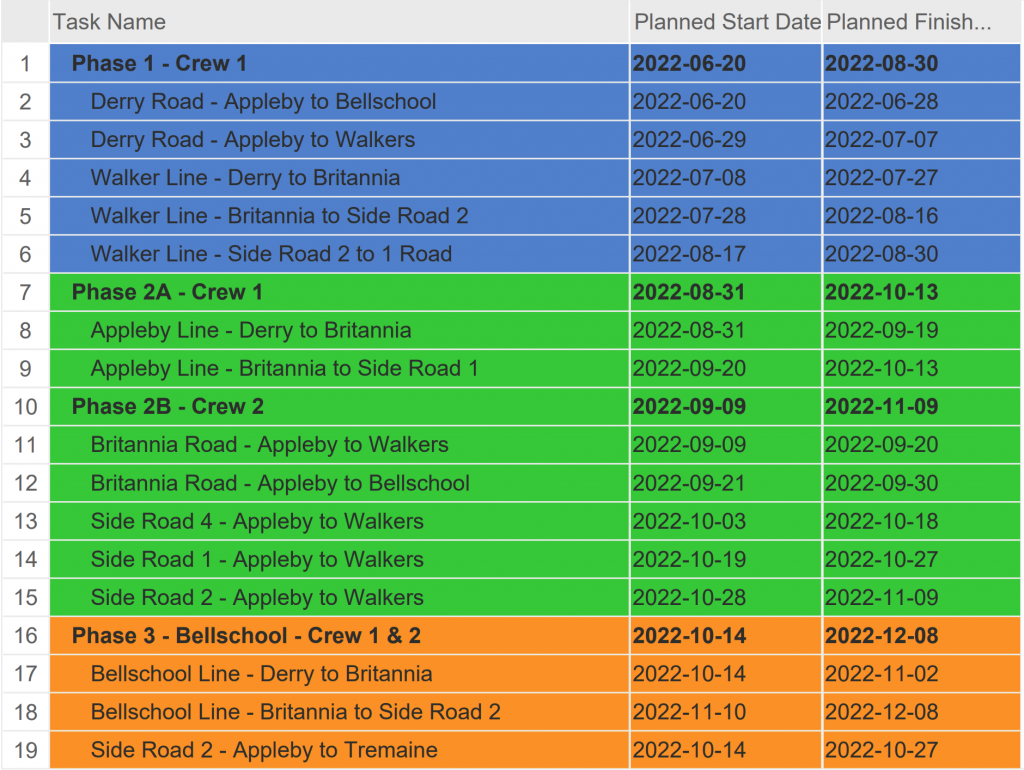

Planned Construction Schedule

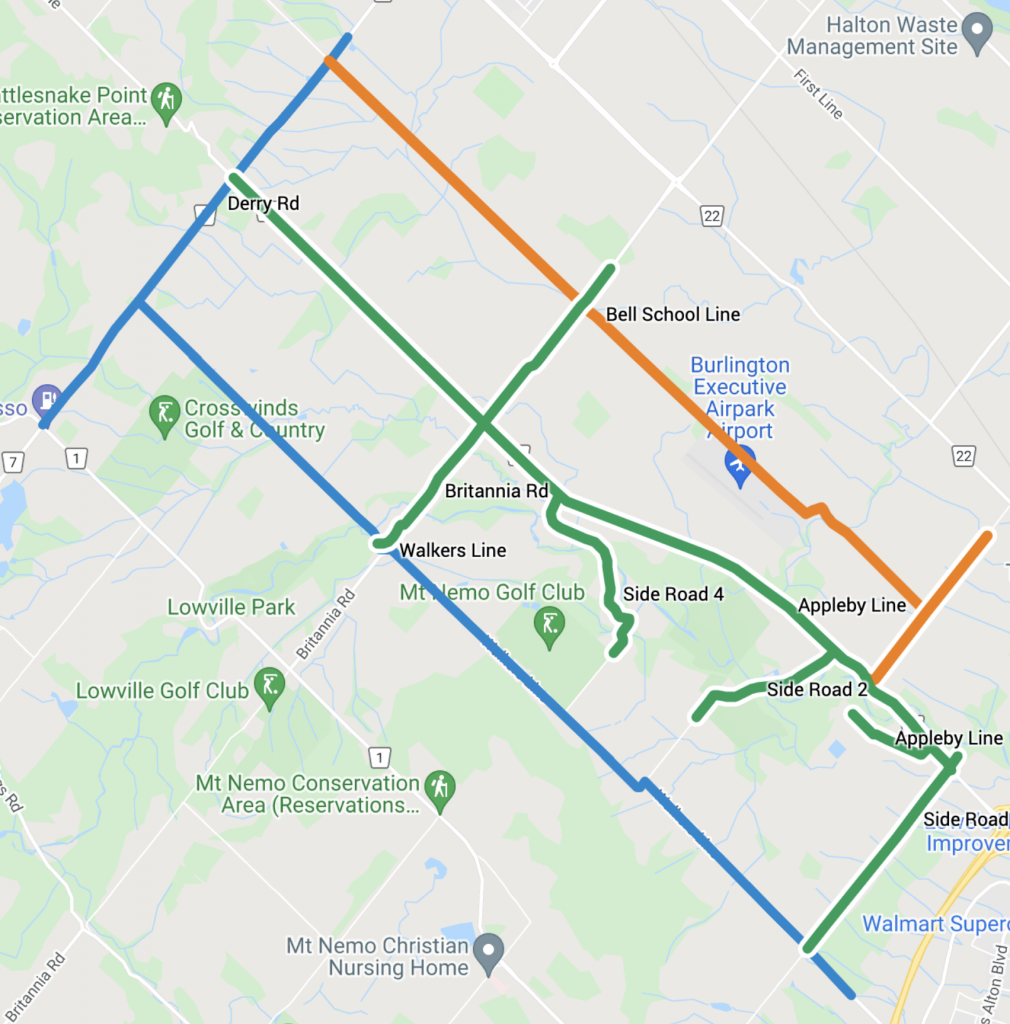

Construction Map

Map colours match highlighted colours on the schedule above.



Both this page and our mailing list will be updated as the project moves along, please join our mailing list by completing the form of the side of this page. To ensure you home is connected to our fibre optic network make sure to also sign up online by clicking the red sign up now button on this page as well.

Should you have any questions related to the available services our customer service team would be happy to assist you. They can be reached via email sales@standardbroadband.ca or telephone at 1-866-569-4147.

If you have any questions specific to the physical construction of the network please contact our FTTH Construction Team who can be reached by email ftthconstruction@standardbroadband.ca or telephone at 1-866-304-9117.
